Project valuation is the process of estimating the value of a project by analyzing its costs, benefits, and risks. It is a critical step in project assessment as it helps to identify the potential risks and rewards associated with the project. Project valuation enables businesses to assess profitability, make informed investment decisions, understand the project’s revenue generation capability, and identify risks, thus helping businesses to manage investment options and risks effectively.
Methods of Project Valuation
There are various methods of project valuation that can be applied depending on the nature and complexity of the project. Some of the common methods are:
- Net Present Value (NPV): This method calculates the present value of the future cash flows of the project minus the initial investment. A positive NPV indicates that the project is profitable and adds value to the business. A negative NPV indicates that the project is not profitable and should be rejected. The NPV method is widely used as it considers the time value of money and accounts for the opportunity cost of capital.
- Internal Rate of Return (IRR): This method calculates the discount rate that makes the NPV of the project equal to zero. The IRR represents the annualized return of the project and can be compared with the required rate of return or the cost of capital to evaluate the project. A higher IRR indicates a more profitable project. However, the IRR method has some limitations such as multiple IRRs, scale problem, and reinvestment assumption.
- Payback Period (PBP): This method measures the time it takes for the project to recover its initial investment. The PBP is calculated by dividing the initial investment by the annual cash flow of the project. A shorter PBP indicates a faster recovery and a lower risk. However, the PBP method does not consider the time value of money, the cash flows beyond the payback period, or the profitability of the project.
Examples of Project Valuation
To illustrate the application of the project valuation methods, let us consider a hypothetical example of a company that is considering two mutually exclusive projects: A and B. The initial investment, expected cash flows, and discount rate of each project are given in the table below:
| Project | Initial Investment | Year 1 | Year 2 | Year 3 | Year 4 | Year 5 | Discount Rate |
|---|---|---|---|---|---|---|---|
| A | $100,000 | $30,000 | $40,000 | $50,000 | $60,000 | $70,000 | 10% |
| B | $150,000 | $50,000 | $60,000 | $70,000 | $80,000 | $90,000 | 10% |
Using the NPV method, we can calculate the present value of the future cash flows of each project and subtract the initial investment to get the NPV. The formula for NPV is:

Using a spreadsheet or a calculator, we can find the NPV of each project as follows:
| Project | NPV |
|---|---|
| A | $79,858 |
| B | $94,358 |
Since project B has a higher NPV, it is more profitable and should be chosen over project A.
Using the IRR method, we can calculate the discount rate that makes the NPV of each project equal to zero. The formula for IRR is:

Using a spreadsheet or a calculator, we can find the IRR of each project as follows:
| Project | IRR |
|---|---|
| A | 28.7% |
| B | 25.9% |
Since project A has a higher IRR, it has a higher return and should be chosen over project B. However, this contradicts the NPV method, which shows the scale problem of the IRR method. Project B is larger in size and has more cash flows, which makes its NPV higher. Project A is smaller in size and has less cash flows, which makes its IRR higher. Therefore, the NPV method is preferred over the IRR method when comparing projects of different sizes.

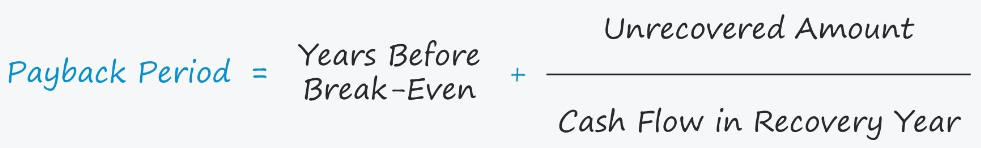

Using the PBP method, we can calculate the time it takes for each project to recover its initial investment. The formula for PBP is:

Using a spreadsheet or a calculator, we can find the PBP of each project as follows:
| Project | PBP |
|---|---|
| A | 2.5 years |
| B | 2.4 years |
Since project B has a shorter PBP, it recovers its initial investment faster and has a lower risk. However, this does not consider the profitability or the cash flows beyond the payback period of each project. Therefore, the PBP method should be used as a supplementary tool rather than a primary tool for project valuation.
Conclusion
Project valuation is an important process that helps businesses evaluate and select the best projects for their investment portfolio. There are various methods of project valuation that can be applied depending on the nature and complexity of the project. Some of the common methods are NPV, IRR, and PBP. Each method has its own advantages and disadvantages, and they may not always agree with each other. Therefore, it is advisable to use more than one method and compare the results to make a sound decision.
I hope this blog entry helps you understand the basics of project valuation and its methods. If you want to learn more about this topic, you can check out some of the sources that I used for this blog post. Thank you for reading and have a great day! 😊
